East Japan Railway Company
May 8, 2007
East Japan Railway Company (JR East) will hold a ground-breaking ceremony on May 30, and begin preservation and restoration* work on the Marunouchi Station Building of Tokyo Station, which is designated as an Important National Cultural Asset.
This preservation and restoration work aims to improve safety conditions and convenience of the station building. In addition, this work will ensure that the historic building and cultural asset is passed on to future generations, and contribute to the formation of a distinctive urban space for our capital city.
* | JR East uses the term "restoration" here in the sense of "returning parts of the existing structure that were modified by subsequent repairs to their original form." |
Overview of restoration work
Overview of facilities
Current | Planned | |
Address | 1-9-1 Marunouchi, Chiyoda-ku, Tokyo | |
Total floor area | Approximately 19,600 m2 | Approximately 43,000 m2 |
Height | Maximum height: Approximately 33.0 m Eave height: Approximately 12.5 m |
Maximum height: Approximately 46.1 m (Including finials*) (However, the height excluding finials is approximately 34.8 m) Eave height: Approximately 16.7 m |
Number of floors | Two above-ground (three floors in some areas), one underground | Three above-ground (four floors in some areas), two underground |
Main uses | Station facility (Approximately 6,600 m2) Hotel (Approximately 5,600 m2) Station gallery (Approximately 1,000 m2) |
Station facilities (Approximately 7,900 m2) Hotel (Approximately 20,800 m2) Station gallery (Approximately 3,200 m2) Parking space (Approximately 3,600 m2) |
Developer | East Japan Railway Company | |
Designer | Design consortium consisting of the East Japan Railway Company Tokyo Construction Office, JR East Tokyo Electrical Construction and System Integration Office, JR East Design Corporation and JR East Consultants Company | |
Builder | Tokyo Station Marunouchi Station Building preservation and restoration work consortium (Kajima Corporation, Shimizu Corporation, TEKKEN Corporation) (3 companies) |
|
Schedule | Start of construction: May 30, 2007 Planned completion: fiscal year 2011 |
Date and time | : | May 30 (Wed.), 2007 |
Scheduled to start at 11:00 a.m. | ||
Location | : | Shinto ritual - Within the Tokyo Station Marunouchi Station Building preservation and restoration work site |
Banquet - Tokyo Station Conference (inside Sapia Tower) |
(Images and other specifications are subject to change depending on future progress.)
Frontal photograph at time of original construction

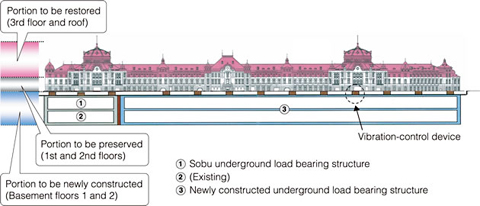

Elevation view after restoration and overview of construction
Images of vibration-control devices
![]() Vibration control rubber |
![]() Oil damper |
![]() |
![]() |
![]() |

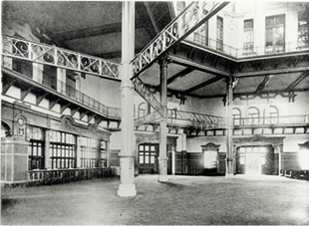

Photograph of dome interior at time of original construction
![]() |
![]() |
![]() |
|

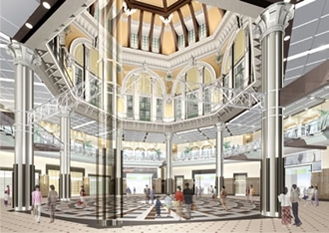

Image of completed dome rotunda |
Image of completed south dome |

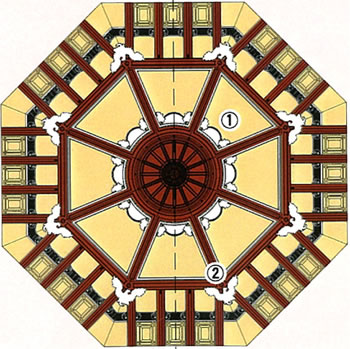

Restoration of dome rotunda
![]() |
![]() |
|
(1) Flower ornamental relief |
(2) Eagle sculpture |
![]() |
![]() |
![]() |
![]() |
|||
(3) Helmet-shaped keystone |
(4) Oriental zodiac (dog) relief |
(5) Sword relief |
(6) Phoenix relief |
* | ![]() |
The dome rotunda colors will be determined after surveys of the present condition, etc. |

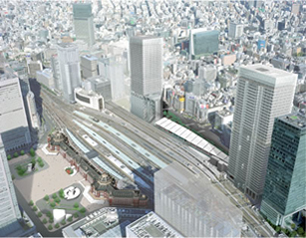

![]() Overall image of completed Tokyo Station City |
![]() |
![]() Image of restored outer wall on track side |
